Why the silence costs you money
A homeowner cannot see your work. They see a torn-up backyard, a truck that was there Tuesday but not Wednesday, and an invoice. What the report prevents, line by line, in a table you can hand to your PM.
Free field guide · 9 pages
One page, twelve minutes, and homeowners stop asking what you did this week. The template, the color rules, and the ledger that makes your freebies count.

9 pp. · PDF
Contents
P. 02
A homeowner cannot see your work. They see a torn-up backyard, a truck that was there Tuesday but not Wednesday, and an invoice. What the report prevents, line by line, in a table you can hand to your PM.
P. 03

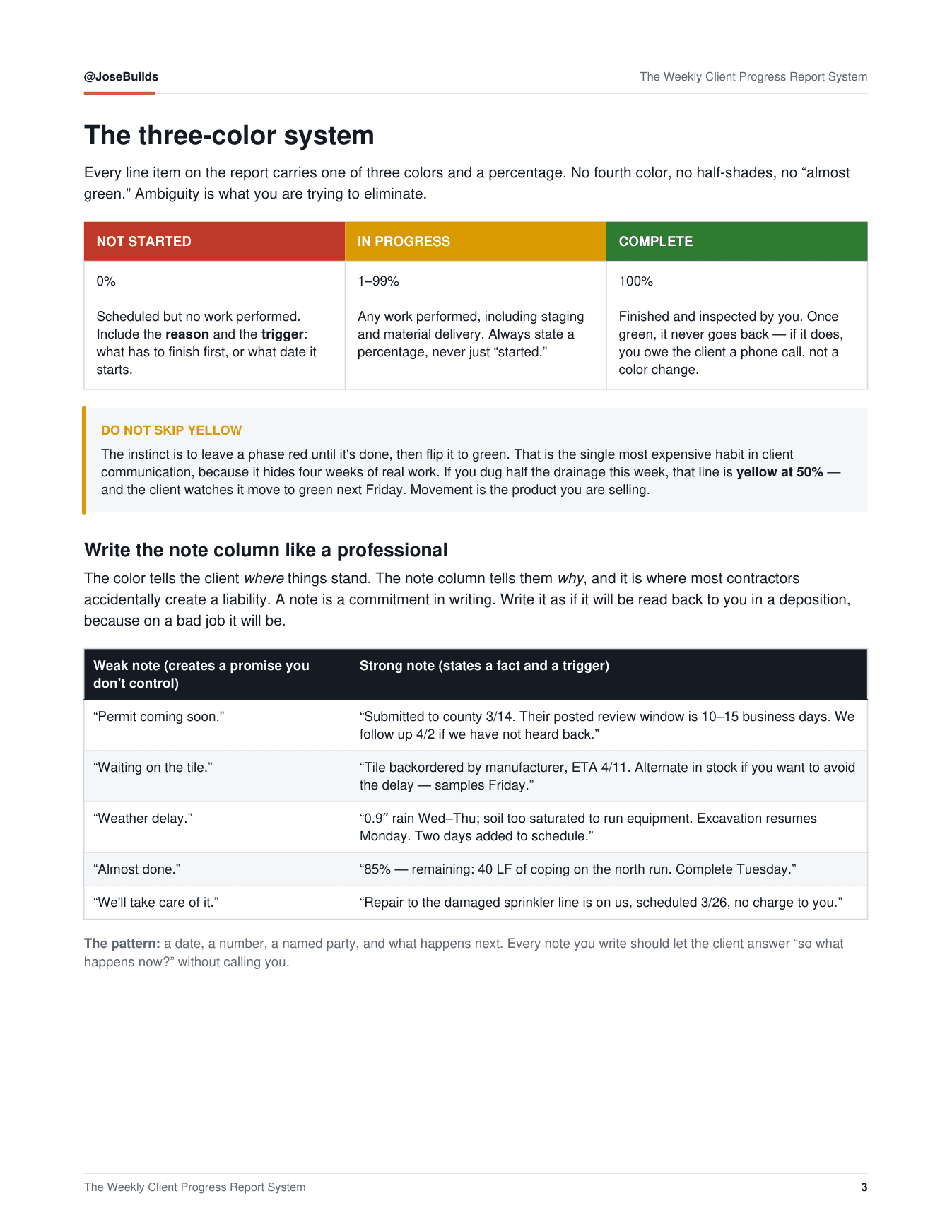

Red at 0%, yellow at 1 to 99% with a real percentage, green at 100% and it never goes back. The instinct to leave a phase red until it is finished is the single most expensive habit in client communication.
P. 04
Pre-construction from design approval through long-lead materials, then every construction phase from site protection to final punch list. The client learns your process by reading the same list every Friday.
P. 05
Every complimentary item with a dollar value attached, priced at full retail rather than your cost, totalled cumulatively. A gift with no price is worth nothing and quietly resets what the client thinks free means.
P. 06
Each draw against a trigger, so the report itself documents that every payment was earned by work already in place. Includes the California deposit cap and front-loading rules under Bus. & Prof. Code §7159.5, with instructions to verify the rule in your own state.
P. 07
Screenshot the actual seven-day forecast for the client’s zip code every week, before Thursday rather than after it. Then Section G: what is coming, and what you need from them, with a date attached.
P. 08

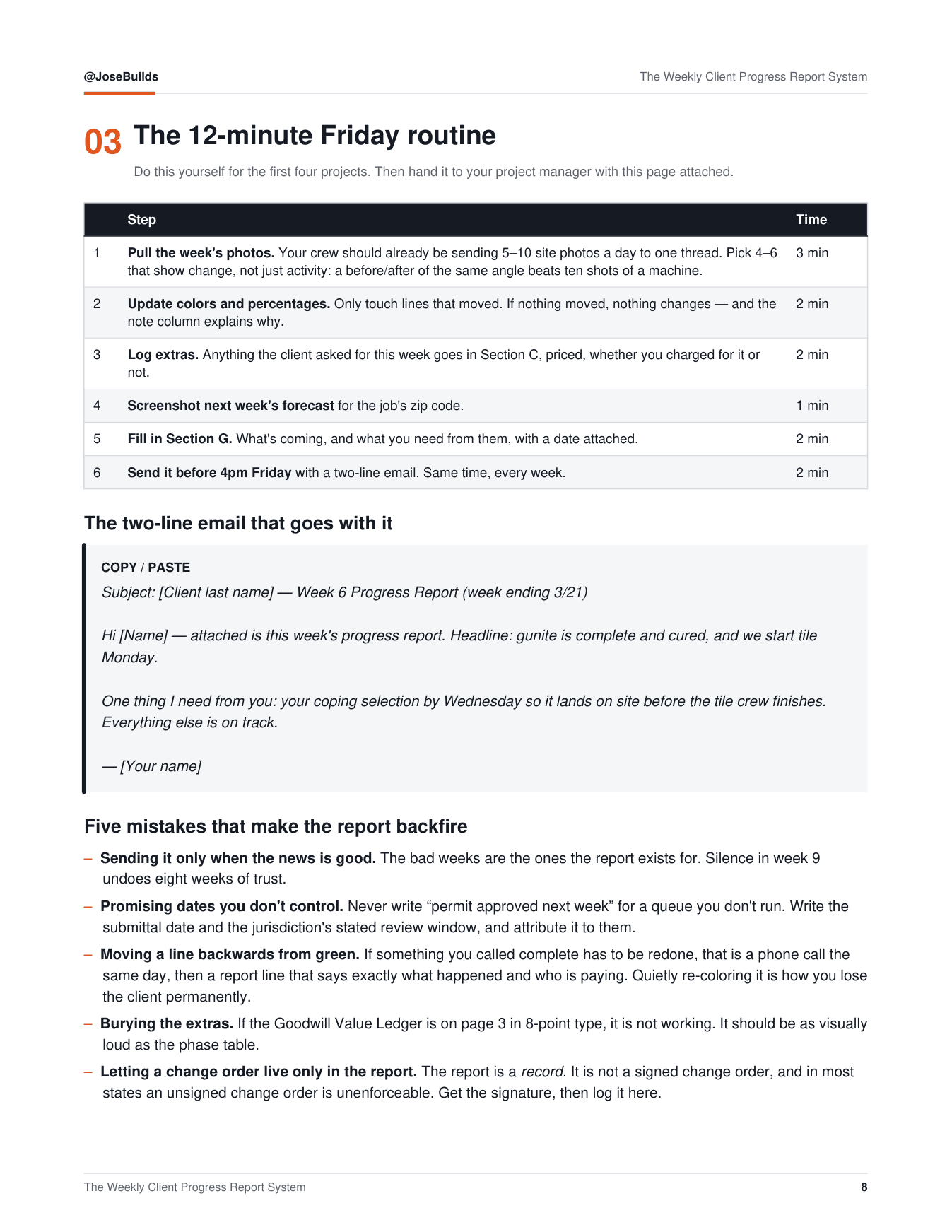

Six steps with a time next to each, from pulling the week’s photos to sending before 4pm. Written so it can be handed to a project manager with this page attached. Includes the two-line email that goes with the report.
P. 09
Pick the active job with the most nervous homeowner and send them a report this week, even if the only honest thing on it is a permit number and a forecast. The second one takes twelve minutes.
Preview
Spreads from the 9-page file you get.



Who wrote this
@joserojasbuilds
Jose still builds. These guides are written out of jobs that were actually run, which is why the details are unglamorous: gate widths, dumpster tonnage caps, and the sentence you say when a homeowner asks for a number while you are standing in the dirt.
This is for you if
This is not for you if
Before you give us your email
Photos tell them something happened. They do not create a record. The report is a timestamped log of what was complete, what the client selected, what they added, and what the weather did, written by you before there is a dispute. That is what a withheld progress payment argument turns on.
Once the template exists, yes. Page 8 breaks the routine into six steps with a time on each. The first report on a job takes longer because you are building the phase list. After that you are only touching lines that moved.
No. Rebuild Sections A through G in whatever you already use, whether that is Google Docs, Notion or your PM tool. Structure matters more than software, and the guide is written that way on purpose.
9 pages · Free · PDF
No call, no calendar link. Enter an email and the guide is on the next screen.
